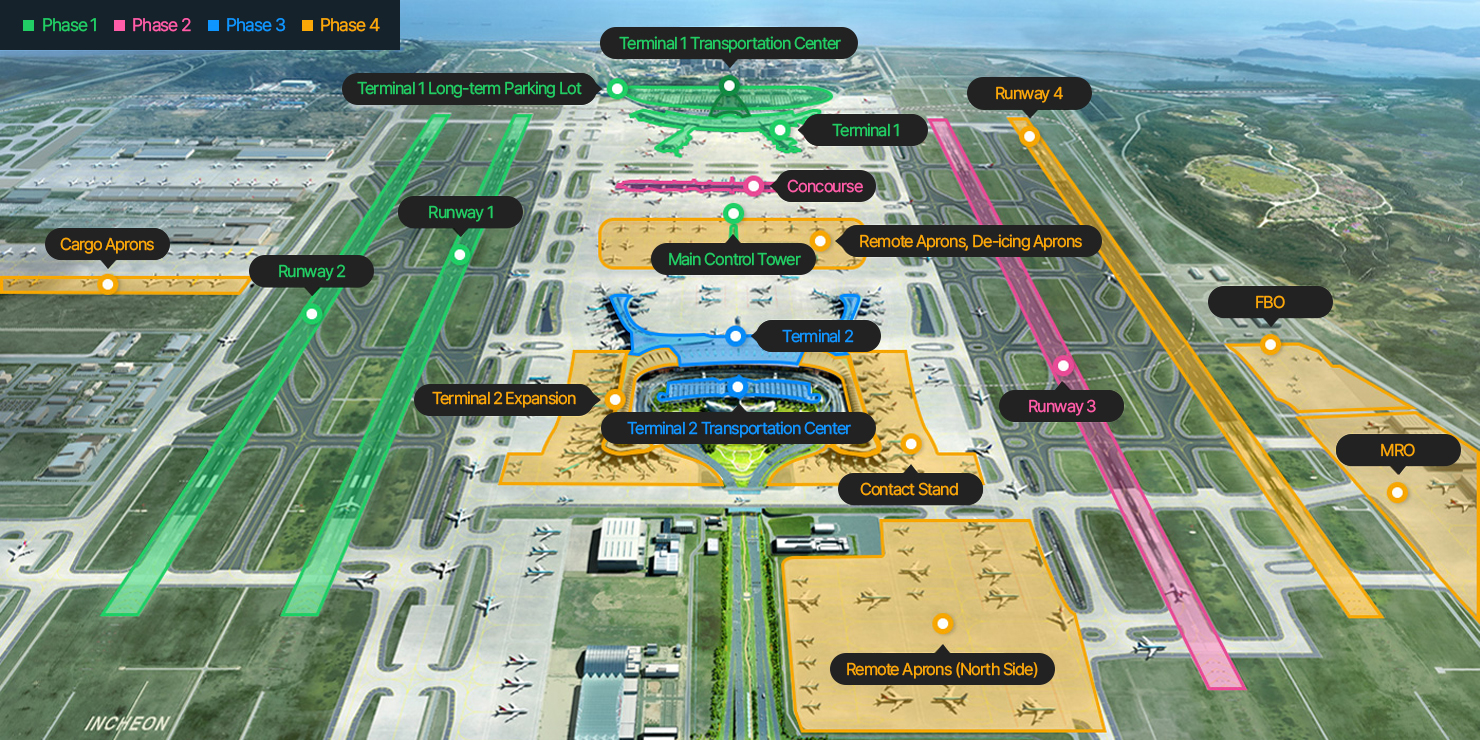

Construction Project Overview by Phase
Phase 1 (1992~2001)
- November 1992
- 101months
- March 2001
Terminal 1 Runways 1 and 2
Passenger Capacity40 Million Passengers Annually
Total Project CostKRW 5.6 trillion
- 1Terminal 1 507,000m²
- 2Runways 2 Runways
- 3Apron Passenger60 Cargo20
Phase 2 (2002~2008)
- January 2002
- 77months
- June 2008
Runway 3 Concourse
Passenger Capacity54 Million Passengers Annually
Total Project CostKRW 3 trillion
- 1Concourse 167,000m²
- 2Runways1 Runway
- 3Apron Passenger60 Cargo20
Phase 3 (2009~2017)
- June 2009
- 103months
- December 2017
Terminal 2 Outbuilding
Passenger Capacity77 Million Passengers Annually
Total Project CostKRW 4.6 trillion
- 1Terminal 2 388,000m²
- 2Apron Passenger54 Cargo11
Phase 4 (2017~2024)
- November 2017
- 84months
- October 2024
Runway 4 Terminal 2
Passenger Capacity106 Million Passengers Annually
Total Project CostKRW 4.8 trillion
- 1Terminal 2 347,000m²
- 2Runways1 Runway
- 3Apron Passenger62 Cargo13
Construction Project at a Glance
Current Status of Incheon Airport
Category | Current | |
---|---|---|
Terminal Area | Terminal 1 | 507,000 ㎡ |
Terminal 2 | 735,000 ㎡ | |
Concourse | 166,000㎡ | |
Annual Capacity | Passenger | 106 Million |
Cargo | 6.3 Million Tons | |
Operations | 600,000 Flights | |
Runway Specifications | Runway 1 and 2 (Phase 1) | 3,750x60m |
Runway 3 (Phase 2) | 4,000x60m | |
Runway 4 (Phase 4) | 3,750x60m | |
Apron | Passenger | 225 locations |
Cargo | 60 locations |
